It is time to build a healthcare system that meets the needs of local communities, now and in the future.

Waterloo Regional Health Network (WRHN) will build a new hospital faster.

Waterloo Region is one of the fastest-growing communities in Canada. Team members, doctors, and volunteers at Waterloo Regional Health Network (WRHN) provide excellent patient care, but the community has outgrown our aging buildings.

Over the next two decades:

  • almost 2 million Ontarians will come to WRHN for care
  • hospital usage for seniors will grow by 170 per cent
  • we will need over 500 additional hospital beds

Building a new hospital will create opportunities for stronger research, education, innovation, and technology in local healthcare. We are also:

  • Renovating WRHN @ Midtown,
  • Expanding WRHN @ Chicopee, and
  • Maintaining WRHN @ Queen’s Blvd. until approximately 2035, when programs and services will move to the new hospital.

By working with communities, health system partners, and Ontario Health Teams, we will be empowered to provide care in ways we could not do alone. This includes partnering with WRHN Foundation to make our shared vision a reality. We will design facilities for future generations of community members, healthcare workers, and researchers right here in Kitchener-Waterloo.

The Vision

Our vision for this project is a Waterloo Region where everyone has access to the highest quality of care, technology, and hospital infrastructure needed to be healthy — now and in the future.

Based on initial conversations with team members, doctors, and community and health system partners, including Cambridge Memorial Hospital and the KW4 Ontario Health Team, we have created a joint vision and submitted it to the government. The vision includes four main parts:

A detailed road map for this work, called a Master Plan, has been developed to help us:

  • meet the growing needs of the communities we serve
  • plan the new hospital
  • make renovations to the existing sites
  • provide high-quality patient care in updated facilities

Project Timeline

In April 2022, WRHN’s two former hospitals received a $5 million planning grant from the Government of Ontario. In April 2025, the provincial government invested another $10 million to continue this work. The grants support WRHN as it maps out how to build a new acute care hospital and update and expand its current sites. They will help us find out which services are needed, the best places for them based on changing community needs, and how to complete the project as quickly as possible.

As this project comes together, WRHN will continue to provide high-quality care across all sites.

Joint Submission for Planning Grant Determining What We Need Identifying Location, Size and Space Planning the Building Construction Begins Operating New Facilities

WRHN will engage health system partners, governments, and the local communities at all stages of the planning process. We need government approval to move through the planning stages.

The New Hospital Site

A new acute hospital is a key part of our plan to care for people in Waterloo Region and beyond, now and in the future.

In July 2024, WRHN announced that the David Johnston Research + Technology Park at the University of Waterloo will be the location of Waterloo Region’s new acute hospital. This site will allow us to deepen our partnership with the University of Waterloo to bring education, research, and innovation together with healthcare delivery.

Site Overview

Site Announcement

During the site selection process, more than 12,000 community members shared their ideas about what the site should have to meet the communities’ needs. Besides the requirements from the Ontario government, we also heard that the new site should:

  • be near major highways and accessible by transit
  • contribute to our goal of building stronger and healthier communities, including offering easy access to nature
  • be near amenities that would make patient and team member experiences better, such as being near businesses, partners, and schools

The University of Waterloo’s David Johnston Research + Technology Park meets and exceeds these requirements.

Planning the Hospital Building

After the site was chosen in July, planning for the new hospital facilities began in September 2024.

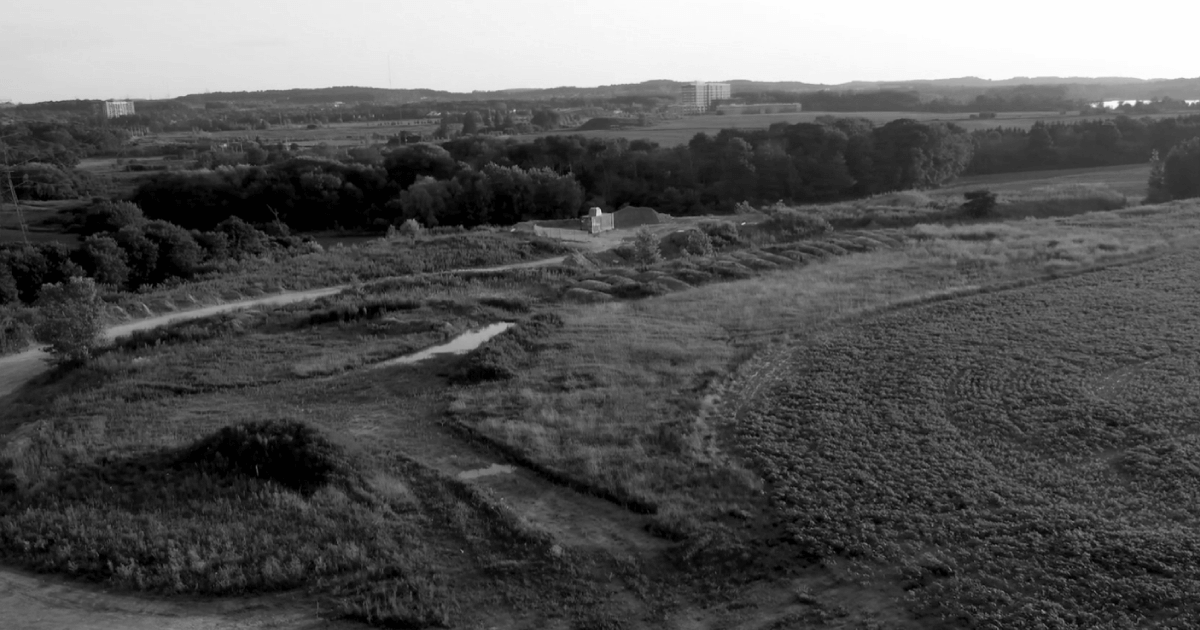

Aerial view of a rural landscape with fields, a dirt path, trees, and distant buildings on the horizon in black and white.

Aerial site plan showing labeled buildings, roads, and green spaces; Stantec logo in bottom left corner.

As part of the site planning due diligence process, architects did a “test-fit” to ensure the building of the new hospital could be accommodated on the site in different phases.

It is important to note that we will engage internal and external partners to decide the final layout of the new hospital. This is a conceptual layout, or first draft, and many elements may change during planning.

Planning Stage 1.3

Functional Program (Stage 1.3 – Part A)

Functional programming looks at every program, service, and activity that will be delivered in the new hospital and the resources and space required to deliver those services. This stage helps us understand how the new hospital will work and what spaces it will need.

To do this, 39 WRHN program teams and user groups with over 250 participants met to discuss details such as:

  • services offered
  • patient volumes and flow
  • department locations
  • hours of operation
  • the number of team members working in each area
  • the projected population growth over the next 10, 20, and 25 years
  • a proposed building solution on the site describing new construction
  • associated engineering reports (such as traffic studies, parking, geotechnical, etc.)

Representatives and subject matter experts also met with healthcare facility planning consultants over three sessions.

The functional program document will provide architects and designers with a clear guide for how the new hospital needs to be designed and built. It was reviewed by each group to make sure it was as detailed and accurate as possible before it was finalized.

Block Designs (Stage 1.3 – Part B)

The Redevelopment Team began the block designs stage in late January 2025. The goal of this stage is to make sure the hospital building’s layout can hold all the spaces needed to work properly while meeting space standards and rules. It also must fit the budget for building and running the hospital.

This work included three or more user group meetings over a four-month period to help determine:

  • design and spatial requirements
  • planning and design objectives
  • phasing plan (what is built first and when)
  • preliminary furniture and equipment list
  • a capital project budget that reflects the costs associated with the building
  • a preliminary post construction operating plan (cost to operate the building upon completion)
  • financial reports (cost of building, local share plan, etc.)

a proposed project schedule that overviews the anticipated submissions approvals and awards of the various project stages as determined upon with the Ministry of Health and Infrastructure Ontario

The Redevelopment Team submitted the functional program to the Health Capital Investment Branch (HCIB) of the Ministry of Health in June 2025. WRHN is now working with the Ministry for approval to move to the next step called Detailed Planning, which you can learn about at the link below.
